Global dashboard

Dashboard > Globalin the Global dashboard, you have access to an overview of your projects (project portfolio). You can group your projects in the form of indicators in order to obtain a relevant vision according to your objectives.

There, you will find progress information and key metrics for all project levels : your projects, their task lists and their tasks.

Note: When you access your Global dashboard for the first time, it is empty. You must then start by creating your first project portfolio.

The indicators

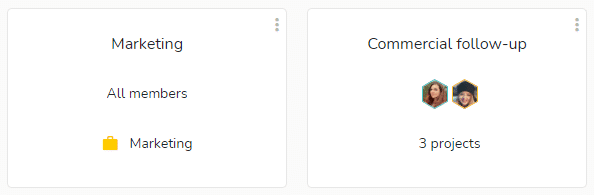

To create a new indicator, click on  “New project portfolio“, and add a title to your indicator. Then, add the projects you want in “Find a project” then members or smart-tags in “All members” (use the toggle icon    to switch from “member” to “smart-tag”) . Then click on “Create”.

To modify or delete an indicator, click on the 3 small dots plus d'options in the top right of the indicator already created, then click on modify or delete. You will be asked for confirmation in the event of deletion.

Click on an indicator to display the detail.

Monitoring your projects

Click on the arrow  to the left of a line to show or hide it.

You can choose to display the metrics in rounded days, in hours or in days and hours. To change the display unit, use the drop-down menu at the top left of the dashboard.

This dashboard and these indicators allow you to synthesize between planning and time management. For more information, see this article: Understanding time management.

The metrics of the Global dashboard

The metrics apply to each level (project, task list or tasks) on the corresponding line.

  • Dates and duration: indicate the start and end dates as well as the total duration (indicator linked to the planning features)
  • Progress: an average of the general progress of the tasks, which takes into account the completed tasks but not the duration of the tasks. (For example if there are four tasks, one of each status including one completed, the progress will be 25%, even if the duration are different.)
  • Highest delay: the greatest delay among all tasks included in the displayed level
  • Cumulative duration of tasks: total duration of tasks included in the displayed level
  • Progress on tasks duration: unlike the progress indicator, this one takes into account the duration of the tasks. Following the previous example, the progress on task duration will be lower than the progress since the completed task represents only a small percentage on the project. This indicator excludes tasks that have no duration.

The visual diagrams of the Global dashboard

At the project level, a circle diagram allows you to view the progress of all project tasks. At the task list level, a bar diagram allows you to view the progress of the tasks included in this list. By unfolding the list panel, you have access to a visual indicator per task (with a detail of the delay per task).

These visual diagrams allow you to visualize the progress of the project thanks to a color code:

  • Red: late (task end date is before today)
  • Orange: on time (today’s date is included within the start-end dates of the task)
  • Gray: coming soon (task start date is later than today)
  • Green: completed

Completed tasks are not taken into account in the project and task list diagrams to facilitate readability. Indeed, the more a project progresses, the more tasks will be marked as completed, and the project could end up being 99% green and the late tasks would no longer be visible enough.
